Multi-Market Battery Dispatch with MPC
A rolling-horizon MPC engine dispatching battery storage across ERCOT’s day-ahead and real-time markets — benchmarked against an LP perfect-foresight ceiling that puts an exact dollar figure on forecast quality.
PROBLEM
A battery’s revenue is a bet on price spreads it cannot see yet. Operators know their forecasts are imperfect, but rarely know what that imperfection costs — so investment cases get built on either blind optimism or blanket pessimism. The engine answers the question directly: on real market data, what is a better forecast worth in dollars, and which dispatch strategy captures it?
APPROACH
A multi-strategy dispatch engine over one shared physical model: rolling-horizon MPC, a global LP as the theoretical ceiling, and threshold / rolling-window heuristics as references — all subject to the same SOC, round-trip-efficiency, and power constraints. On top of it: solar-plus-storage hybridisation that captures inverter clipping at the point of interconnection, battery sizing over a power-by-duration matrix, a curtailment-elimination frontier, and a revenue-sensitivity sweep of four strategies against eleven forecast-improvement levels. Live on years of ERCOT nodal data through a Streamlit + Supabase stack, with the market-agnostic core built to re-target other power markets by swapping the data layer.

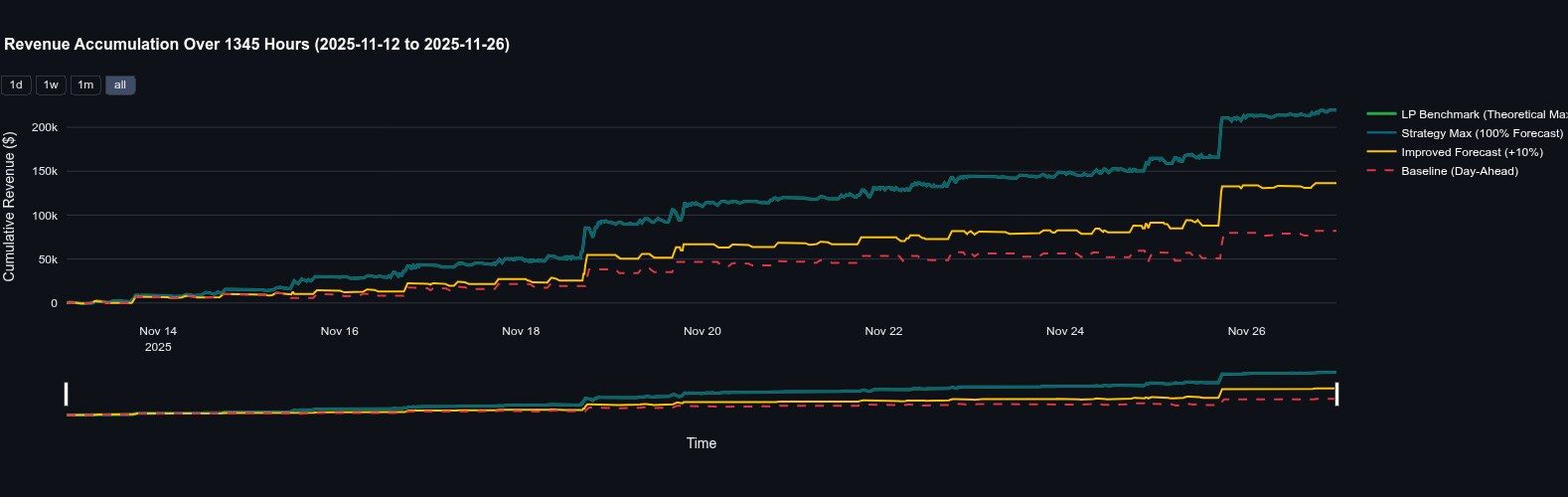

The distance between the baseline (day-ahead only, dashed red) and the LP perfect-foresight ceiling (green) quantifies exactly how much revenue an imperfect forecast leaves on the table.

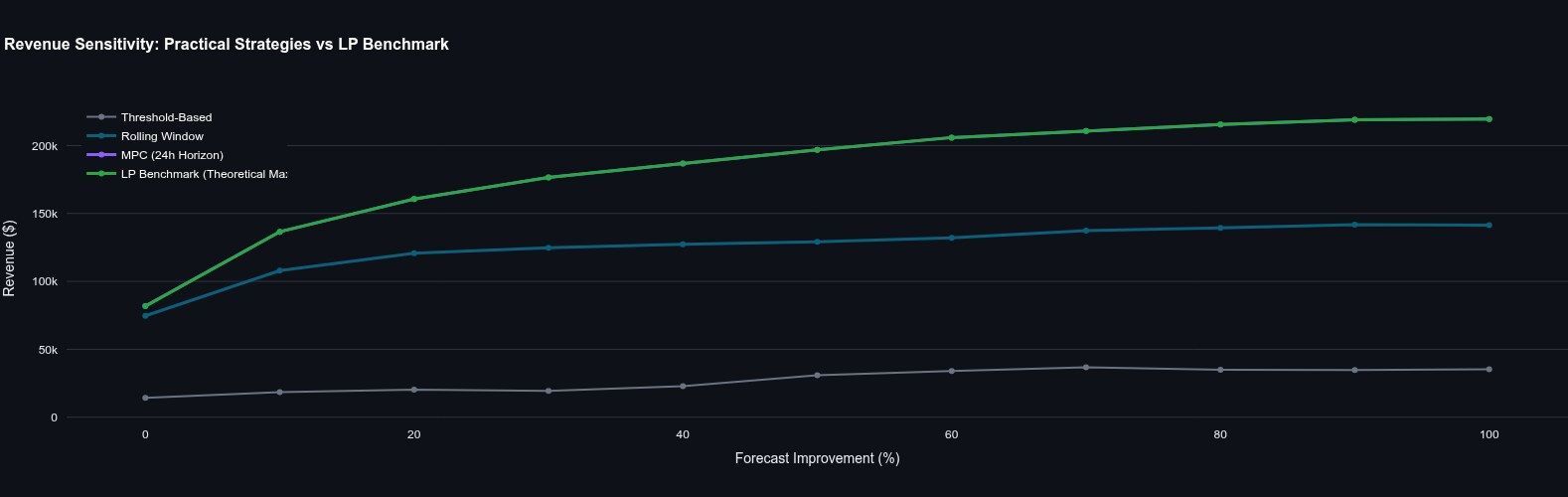

Four strategies swept against eleven forecast-improvement levels. MPC with a 10% better forecast turns $82k of baseline into $137k; with a perfect forecast it converges on the $220k LP ceiling.

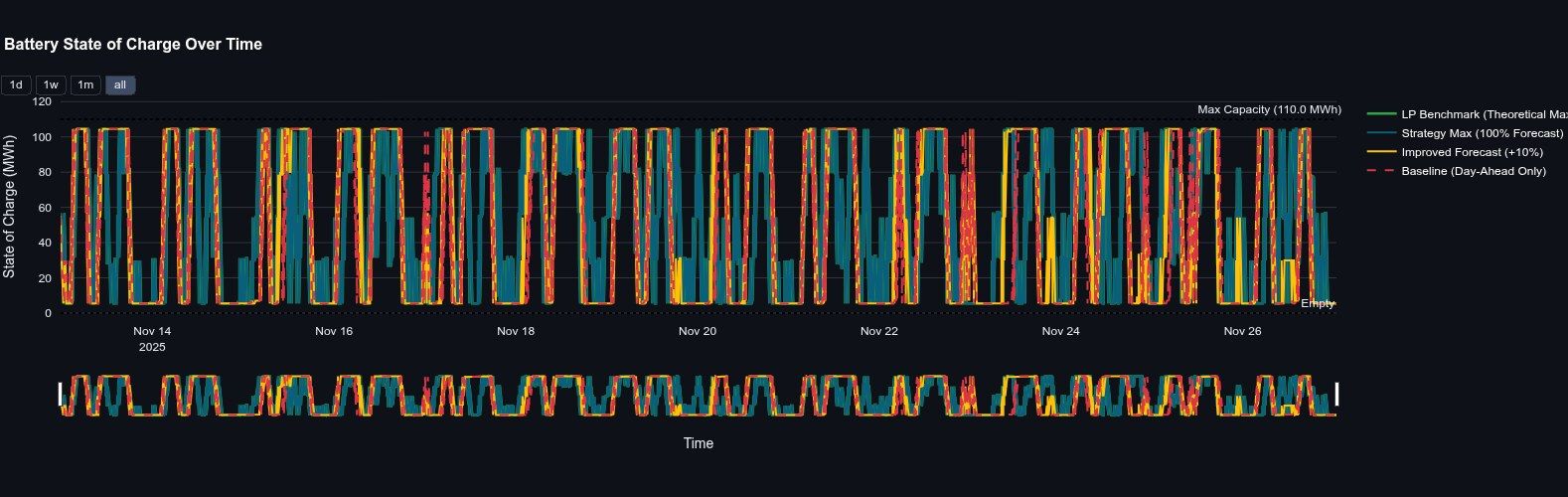

The same physical battery model under every strategy: SOC limits, round-trip efficiency, and power constraints are enforced by one shared solver, so the only difference is decision quality.
DEGRADATION
The piece most dispatch tools ignore: every cycle spends the asset. In an industry pilot I built warranty-aware dispatch around a 4-D warranty lookup — ambient temperature × mean SOC × C-rate × daily cycles mapped to capacity and round-trip efficiency per year — integrated as a physical constraint of the optimiser. A year-by-year loop (annual LP, warranty lookup, capacity ratchet) validated over four years of UK market data reached 94.7% of the perfect-foresight optimum with only one day of visibility, benchmarked against the industry’s two-hour BESS index — with revenue confidence intervals from market scenarios crossed with degradation bands.
OUTCOME
A public engine you can drive yourself — the live demo runs the MPC optimiser on real ERCOT data at every interaction. In the 15-day example window a 100 MW × 1.1 h hybrid asset books $63,724 of clipping arbitrage on top of $551,093 of hybrid revenue, and a 10% forecast improvement is worth $55k against an $82k baseline. A private shadow monitor tracks dispatch against the optimum, and the degradation layer prices what every one of those cycles costs the asset.
